Don't Be A Federal Eminent Domain Victim

7/24/2023

2 Comments

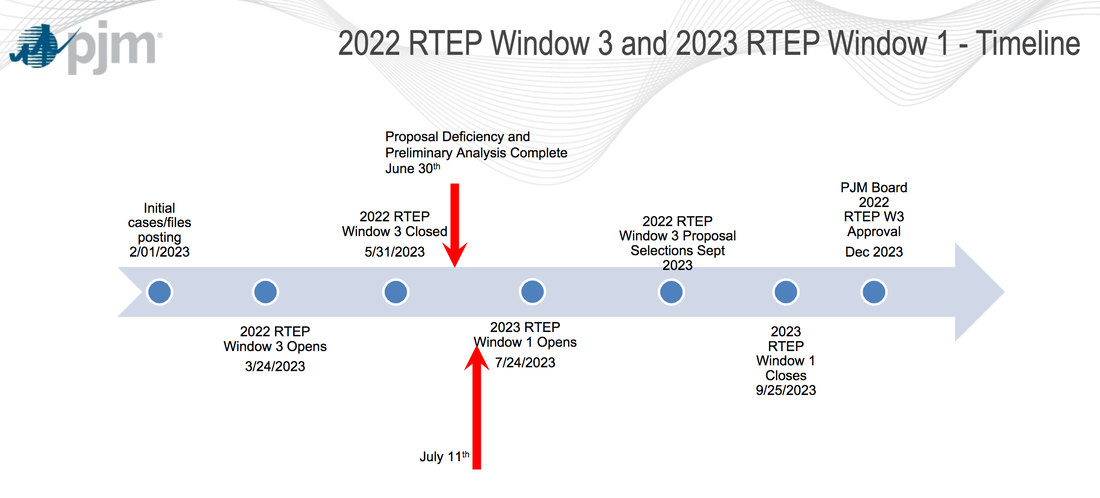

There's still time to get your comments in to the U.S. Department of Energy on its plan to let transmission developers request National Interest Electric Transmission Corridors (NITECs) that coincide with financially lucrative transmission projects.  Once the DOE designates a NIETC at the request of a project developer (merchant or otherwise), the project owner will have FEDERAL EMINENT DOMAIN to take your property against your will.  Don't go quietly without a fight!  Tell the DOE that you object to its plan to allow greedy transmission developers to decide where, when, and why to build new transmission.  The back yard you save may just be  your own.

New transmission has been juiced by government giveaways of taxpayer cash.
DOE says it intends to use designation of NIETCs as a pedestal for its cash giveaways.  A transmission project with an NIETC is suddenly eligible for piles of taxpayer cash.  Funny how that works, when the enabling statute actually says NIETCs should be designated for the purpose of benefiting electric consumers.

Once a developer requests a NIETC for its project and DOE approves, permitting for the transmission project shifts to the Federal Energy Regulatory Commission.  FERC wants to open a separate permitting process for such a project, to run at the same time as your state permitting process.  That way, if your state denies a permit, FERC is standing there poised with its rubber stamp to overrule what your state utility experts decide.
Don't miss your opportunity to let DOE know what you think online so that you don't have to stand outside FERC's building and sing a song like this some day.

Ready?  Go here.

Just fill out the form.  You can even check a box to remain anonymous.  You don't have to give your name (although, personally, I always prefer to own my words).

The deadline for comments is just a week away on July 31!

Don't know what to say?  If the information in this blog isn't enough for you to compose a comment, then you may find inspiration reading some of the comments that have already been submitted.  They cover a wide range from obsequious greedy transmission developers, to other government agencies, to citizens just like you.

Get your comments in now before time runs out!!!
2 Comments

Beware the Bait and Switch from unscrupulous transmission companies

7/20/2023

0 Comments


How in the world did New York permit a transmission project to use eminent domain to take private property without adequate notice to and due process for affected landowners?  According to this article, landowners who had been told that the Champlain Hudson Power Express transmission line would be buried entirely in Lake Champlain, the Hudson River, and transportation rights-of-way are now being threatened with eminent domain unless they allow burial of the project in their back yards.  A local government official uses the word "blindsided" to describe recent efforts to get landowners to sign "voluntary" easements coerced by threats of eminent domain.

How did this company get eminent domain in the first place if it had agreements to use bodies of water and transportation rights-of-way?  The company did not need eminent domain to acquire right-of-way that was already under contract.

It seems that TDI's original plan to stay completely in the river was tanked by environmental concerns on certain stretches of the river.  Environmental interests prevailed, and the project was routed out of the river and over land in certain areas.  However, local governments were told that the project would be routed completely along existing rail corridors.
“Initially, the town was told it would be 100 percent by rail,” said Glenville Town Supervisor Chris Koetzle of what CHPE first said when they explained that part of the land-based section of line would go through his town.
But then TDI "discovered" there were utility equipment and other obstacles along the rail corridors that they had to avoid, requiring deviation from the rail corridor to find a route across private property.  And what did TDI do then?  Did it go back to regulators and explain itself?  Did it contact the towns and notify them of the change?  Did it meet with landowners to discuss its dilemma?
But over the last few months, [the town] started getting phone calls from residents of the Woodhaven neighborhood who were contacted by CHPE for easements.
Instead of doing the morally correct and honest thing and making this very important change public, the company put the squeeze on affected landowners and threatened them with eminent domain if they did not sign easements.  How is this legally allowed?
Negotiations over the easements and the idea the land could be taken through eminent domain has some people contacting their lawyers.

“I’ve had a couple of people call me,” said Patrick Seely a lawyer with the Jones Hacker Murphy firm in Troy. He hasn’t actually been retained, but noted that in easement cases, there is often a negotiation. “A little bit of horse trading goes on all the time,” he said.

But those landowners in easement cases would have been notified that their property was needed for the project way back in the project permitting stage.  Once notified, the landowner would have had the option to participate in the permitting case and appeal any decision they did not agree with.  These late-to-the-game landowners have been stripped of due process.  They absolutely should contact a lawyer, but not one who only sees their case as a way to cash in by negotiating easement agreements, instead of questioning whether the landowner received proper legal notice of the project in the first place.

And they might want to find out whether this was an honest mistake for which there was no other remedy than eminent domain and routing across private property, or was this done as a result of carelessness?  If the original plan to stay in the river wasn't stopped by environmental concerns, would any of this be happening?  What did the company know about obstructions to a rail route when it decided to put it there?  Might routing on road shoulders or a combination of road and rail have been a better choice?  Seems very odd that there were no options for route planning.  Is the company just losing its patience and calling it "good enough" in order to stop the financial bleeding a lack of proper planning from the beginning has caused?

Maybe TDI shouldn't have spent so much money showering local governments and environmental interests with cash in exchange for support for its project.  And maybe local governments shouldn't have accepted TDI's dirty money before the project's route was confirmed.  A good lesson in payoffs all around.

But what about those landowners?  A solution must be found, and it can't be eminent domain.  This project got so close to getting done without creating involuntary victims.  And now it seems to have simply given up.

Disappointing.  I hope the next company that attempts to site a transmission project buried underwater and on existing rights-of-way can stay the course to success.  Meanwhile, landowners near TDI's other transmission project, New England Clean Power Link in Vermont should beware.  Looks like TDI has already paid for the support it thinks it needs for that project.  Is eminent domain on private property next?
0 Comments

Fits of Fantasy

7/19/2023

0 Comments


I think the phrase is actually flights of fantasy, but... well, you'll see.

Data centers.  Have you ever really thought about them when you're poking around online and the world is at your fingertips?  Probably not, but we have to have a place to store all our big data that we just can't seem to part with.  We're full-blown digital hoarders.

Data centers use a huge amount of electricity, and they must have a steady supply 24/7, 365.  Data centers depend on enormous backup generators (that run of fossil fuels) in the event of a power outage.  Data centers require on demand, reliable power.

But this industry fit of fantasy proclaims that we can run data centers on 100% renewable power.  No, we can't.  We don't have the technology to produce on-demand supplies of electricity from 100% renewable generators.  Wind and solar only run part of the time, when their fuel is made available by Mother Nature.  A data center that relies 100% on wind and solar will 100% use its backup generators for at least 50% of the time.  And doesn't that defeat the purpose of "clean energy" in the first place?

The fit of fantasy examines several data center clusters in the U.S., including the nation's largest data center market in Northern Virginia.  Northern Virginia data centers operate on 94% fossil fuel electricity.  94%!!!!  That's the type of power needed to power a 24/7 365 power hog like data centers.

But, never fear, this fit of fantasy thinks the problem can be solved by building new transmission.  I'm going to guess the author hasn't bothered to examine PJM's recent competitive solicitation for new transmission projects to solve the issue of powering Northern Virginia's data center power suck.  It looks like this.
One proposed solution simply imports more fossil fuel electricity from the Ohio Valley.  That's sure to speed the "transition" (to 100% fossil fuel power).  Other solutions pump fossil fuel electricity in from Pennsylvania.  It's all about importing more fossil fuel electricity instead of building reliable renewable generators near the load.  That's because, first of all, PJM can only order transmission, not generation, and second wind and solar cannot supply reliable power that will run a data center 24/7 365.

Where's the disconnect?
The superficial examination of how easy it will be to build new transmission is where this fantasy starts having fits.
Plans to transition U.S. data centers to renewable energy power sources are impeded by current utility transmission infrastructure. The main problems are outdated power lines, delays in planning and permitting for new transmission and distribution projects and supply chain bottlenecks. Upgrading existing transmission lines can take as long as three years, according to the Lawrence Berkeley National Laboratory, due to time-consuming regulatory hurdles, resulting in multi-million-dollar costs.

An electric line is just an empty extension cord, not plugged in to anything.  Unplugged extension cords do not produce electricity.  What you need is another plug -- a reliable generator on site.  Having extra extension cords won't produce power if there's no place to plug them in.  Not having enough extension cords is not the problem.  "Time consuming regulatory hurdles" is something this author doesn't know anything about.  There are no hurdles for simple rebuilds on existing rights-of-way.  More extension cords are not the answer.


Upgrading power transmission infrastructure to accommodate renewable energy sources is a top priority for utility companies. Recently adopted federal legislation provides $2.5 billion in public funding for this effort. Additionally, the Federal Energy Regulatory Commission (FERC) plans to study and address these ongoing issues. Utility companies are cooperating with regulators, city officials, operators and developers throughout the U.S. to improve connectivity.

Do you have any idea how much "power transmission infrastructure" costs?  A good sized transmission project that connects renewable energy resources easily costs MORE THAN $2.5 billion.  Qu'est-ce que "public funding"?  There's no such thing.  What they meant to say is TAXPAYER FUNDING by people like you.  This legislation won't do anything but complicate things.  How many times has the federal government run to the rescue with handfuls of cash and solved a problem efficiently and cheaply?  FERC plans to study and address them?  How?  Do tell!  I'm betting you don't even have a ghost of an idea.

This report highlights select regional data center markets that are working to advance renewable energy power availability and solve transmission and distribution issues. These markets all depend on local renewable energy sources and are at the forefront of a transition necessary for the data center industry to grow on a sustainable basis.

WTH?  These markets depend on local renewable energy sources?  Where are they going to put millions of acres of solar panels and wind turbines in crowded Northern Virginia when every square inch of available real estate is covered with data centers, warehouses, and urban sprawl?  What you're depending on is faked "plans" by utilities checking the politically correct boxes while raking in a huge pile of money.  Dominion doesn't give a fig about the environment, or your data center.  It only loves money.  Dominion will say or do anything, even if it knows what it is saying is impossible, as long as foolish data center companies enable bigger profits for Dominion.

The data center industry cannot grow on a sustainable basis unless they starting building nuclear plants inside the data centers.

Fits of fantasy.  No matter how much fiction you write, you cannot force it into being.
0 Comments

Transmission Leftovers

7/16/2023

2 Comments


Some things are better the second time around, like lasagna and chili.  Transmission projects, however, are not good leftovers.  Once a transmission idea is proposed to the public, vehemently contested, and eventually shelved as unneeded and impossible, it can never come back from the dead.

Or can it?

The Infrastructure Investment and Jobs Act and the Inflation Reduction Act have created a new transmission feeding frenzy from coast to coast.  Now that the government is giving away your tax dollars to provide incentive to build new transmission "for renewables," utilities and transmission developers are falling all over themselves to belly up to the buffet.  There is no actual plan for what transmission needs to be built, any transmission will do.  It's about quantity, not quality.  They just can't propose transmission fast enough.  And apparently some utilities are simply recycling old transmission projects from the last decade that were never built.

Remember the Mid-Atlantic Power Pathway, or MAPP, project?  Proposed around 2007, this hotly opposed transmission project across Maryland's eastern shore was finally abandoned several years later, citing lack of need.  The utilities behind this horrible idea were fully reimbursed for their sunk costs by ratepayers who would have "benefited" from the project.  If my memory serves, it was something like $80M that we paid for a transmission project that was never constructed.

The MAPP project is back, one of dozens of new transmission proposals currently being evaluated by grid planner PJM.  They even recycled the name... once again calling it MAPP.
Project title:  Mid-Atlantic Power Pathway (MAPP)

Project description:  Exelon is proposing a 230 mile, 500 kV AC / 400 kV DC high-voltage transmission line originating in Northern Virginia, crossing Maryland, traveling up the Delmarva Peninsula and terminating in southern New Jersey.

Do they think the folks who fought MAPP have forgotten?  It's only been 15 years.  They remember, and many are still around, with all the knowledge they gained fighting MAPP the first time.

Transmission fatigue is a thing.  Communities who have fought a transmission line are instantly opposed to another proposed for the same area, and they know what to do because they've ridden in this rodeo before.  A recent transmission proposal through New Hampshire is giving communities that fought the scrapped Northern Pass project PTSD.
When four representatives of National Grid came before Concord City Council on Monday to start the long process of expanding a power line through the state bringing electricity from HydroQuebec, they soon encountered a ghost.

“Our community still suffers from PTSD with regard to Northern Pass,” Councilor Jennifer Kretovic told them. “When you mention the words HydroQuebec, that will automatically raise concern.”

The four representatives nodded glumly.
And stupidly, I might add.  Transmission is bad enough without ghost projects adding to the hatred.

It seems that every contested and vanquished transmission project from the past 15-20 years has been resurrected.

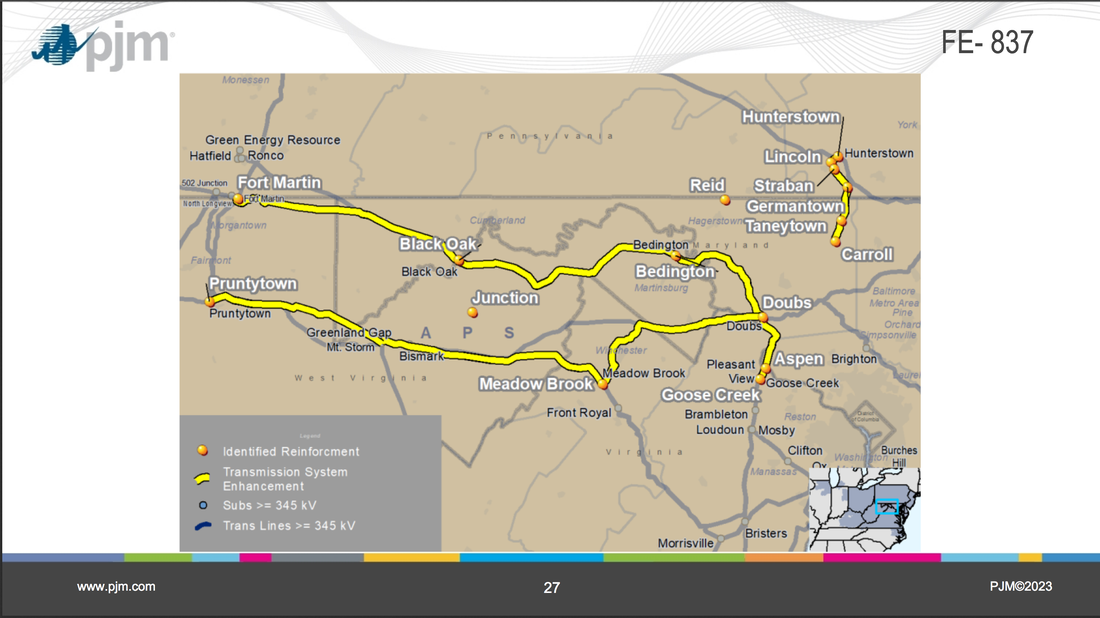

Remember PATH, the Potomac-Appalachian Transmission Highline?  It's back.  But instead of just the revised, re-routed project that PATH finally settled on, former PATH partner FirstEnergy has proposed BOTH the original PATH route through Morgan, Berkeley and Jefferson Counties AND the revised PATH route through Frederick County, VA, southern Jefferson County, WV, Loudoun County, VA and Frederick County Maryland.  This is FirstEnergy's recent proposal for PJM's competitive transmission window.  On a map, it looks like this:
The northern line on the map is described like this:
Component title:  Fort Martin - Doubs 500 kV #1 Line

Project description:
Construct ~158 miles of new 500 kV line from Fort Martin Substation to Doubs Substation.Terminate the new transmission line and revise relay settings at Doubs and Fort Martin substations.Install fiber OPGW along the new line route. The construction of this new line will require the acquisition of 158 miles of new right-of-way, forestry clearing, permitting, and access road construction. Re-terminate the Bismark 500 kV Line at Doubs Substation. Aerial LiDAR will be required. This new transmission line will require Proposal Components 1 (Doubs Substation - Install500 kV Breaker), 2 (Doubs Substation - Expand 500 kV), and 4 (Fort Martin Substation - Install 500kV Breaker) to be completed.

This new 500 kV line will be constructed in West Virginia, Virginia, and Maryland. Full Applications
will be required in each state. - It is assumed that the new 500 kV line will parallel existing ROW for approximately (85.6) miles and require (74.4) miles of new ROW not adjacent to existing ROW. It is assumed that no existing lines will be overbuilt with double circuit structures, but existing line rebuilds will be considered where applicable. - Approximately (695) parcels will be affected by the line route. Assumed 5% condemnation (35 parcels).

The right-of-way width is assumed to be 200 ft. This width is based on the widest ROW needed for
500 kV and does not account for structure configuration or span lengths. Widths needed may vary upon final design.

The new Fort Martin-Doubs #1 500 kV Line will be constructed on double circuit 500 kV tubular
steel monopole and two-Pole structures. The second 500 kV circuit is to be left vacant and installed at a future date. - The average span length is 1200 ft. - It is assumed that the new double circuit monopole structures will have an average height of 180 ft. Final structure heights will need to be determined during project development. FAA filing and application may be required. - The new structures will utilize custom 500 kV V-string and double I-string suspension and dead-end insulator assemblies.

This new 500 kV line provides a direct connection from the west side of the system to the east
side. - This new line provides the ability to install a second Fort Martin - Doubs 500 kV Line on the same structures, without additional right-of-way acquisition. - This new line route will provide the opportunity to loop the Fort Martin - Doubs 500 kV Line into Bedington and/or Black Oak substations in the future, if necessary for reliability or resiliency. - Greenfield construction is assumed due to outage constraints, but existing rights-of-way and corridors to rebuild lower voltage lines will be considered where applicable.
A portion of the southern line on the map from Meadow Brook to Doubs is described like this:
Component title:  Meadow Brook - Doubs 500 kV Line

Project description:  Construct 55.3 miles of new 500 kV line from Meadow Brook Substation to Doubs Substation.Terminate the new transmission line and revise relay settings at Doubs and Meadow Brook substations. Install fiber along the new line route. The construction of this new line will require the acquisition of 55.3 miles of new right-of-way, forestry clearing, permitting, and access road construction. Re-terminate the Meadow Brook - Loudon & Meadow Brook - Front Royal 500 kV lines at Meadow Brook Substation. Aerial LiDAR will be required. This new transmission line wil lrequire Proposal Components 1 (Doubs Substation - Install 500 kV Breaker), Component 2 (Doubs Substation - Expand 500 kV), and Component 3 (Meadow Brook Substation - Expand 500 kV) to be completed.

This new 500 kV line will be constructed in Virginia, West Virginia, and Maryland. Full Applications
will be required in each state. - It is assumed that the new line will parallel existing ROW for approximately (22.8) miles and require (32.5) miles of new ROW not adjacent to existing ROW. It is assumed that no existing lines will be overbuilt with double circuit structures, but existing line rebuilds will be considered where applicable. - Approximately (146) parcels will be affected by thel ine route. Assumed 5% condemnation (7 parcels).

The right-of-way width is assumed to be 200 ft. This width is based on the widest ROW needed for 500 kV and does not account for structure configuration or span lengths. Widths needed can vary upon final design.

This new line will be constructed on single circuit 500 kV tubular steel monopole structures with an
average span length of 1200 ft. - The new structures will utilize custom 500 kV V-string and double I-string suspension and dead-end insulator assemblies. - New single circuit structures will have an average height of 150 ft.

This new 500 kV Line will provide an additional and much shorter electrical path between Meadow
Brook and Doubs linking the Black Oak-Bedington corridor with the 'AP South' corridor. - Greenfield construction is assumed due to outage constraints, but existing rights-of-way and corridors to rebuild lower voltage lines will be considered where applicable.
In addition, FirstEnergy proposed building a new 50 mile greenfield transmission line from Pruntytown to Meadow Brook.

It's not an "either/or" proposition.  FirstEnergy wants to build BOTH old PATH ideas this time.

Here we go again!

Is this new transmission required to expand renewable power?  Look at the map, it's self-explanatory.  PJM is soliciting proposals to move more coal-fired electric generation from plants at Ft. Martin and Pruntytown into the Washington, D.C. suburbs.  New generation is needed there because these areas have closed a whole bunch of the "dirty" coal and gas fired generation that used to keep their lights on.  Instead of replacing what they closed with local renewables, they're burying their heads in the sand and pretending they don't need any new generation.  However, they're also building new data centers that use an enormous amount of power and leaving it up to grid planner PJM to find a way to keep the lights on and the data centers humming.  The new PATH is one proposal for PJM to do just that.  Hardly "clean and green" is it?  It's a step back 20 years in time, when PATH was proposed to move 5,000 MW of coal-fired electricity from southern West Virginia to the D.C. metro area.

So, what happens next?  PJM says it will select projects from its huge proposal list in September.  Once selected, it proposes to have the favored projects approved by its Board in December of this year.  See timeline here (these projects are in 2022 RTEP Window 3):
After being beaten into submission the first time, PATH abandoned its project and collected over $150M from electric customers like us for a project that was never built.  How much will it cost us the second time around?

Keep your eyes on this one.  PATH did not happen the first time due to widespread opposition.  We're still here and we remember.
2 Comments

Transmission Turf War in Oklahoma

7/10/2023

0 Comments


New government giveaways have created a land rush in the Oklahoma panhandle to build a forest of wind turbines.  Greedy energy speculators have arrived to exploit Oklahoma and plunder its riches for their own gain.

The Oklahoma panhandle has long been a wind energy speculator's holy grail due to its wind speeds, however it has also been impossible to develop due to its remote location far from gigantic transmission lines for export to other states.  First there was Clean Line Energy Partners, who thought if they built a 700-mile transmission line from the panhandle to Memphis that other companies would build wind turbines in the panhandle and energy consumers in Memphis would eagerly buy whatever electricity was delivered.  Oops!  That didn't work out so swell.  There never were any customers for that idea and Clean Line went belly up after wasting $200M of its investors' money.  However, on its way to dissolution, Clean Line sold the remnants of its project idea to NextEra Energy Resources.  NextEra bought only the Oklahoma portion of the project.  The purchase included rights-of-way that has been acquired by Clean Line.  NextEra has been sitting on this purchase like a chicken on an egg since 2017, waiting for the political tides to change.

And then there was WindCatcher, which wound up about the time Clean Line wound down.  In fact, Clean Line tried to get WindCatcher interested in buying its Oklahoma assets, instead of taking a different route.  WindCatcher was a scheme by American Electric Power subsidiary Public Service Co. of Oklahoma and renewable energy company Invenergy to build the country's largest wind farm in the panhandle and then connect it to eastern Oklahoma via a new transmission line built by PSO.  PSO's first route went just north of Tulsa and was refused by the Osage.  PSO's alternate route went just south of Tulsa to connect near Jenks, but a little town named Bixby formed a tornado of opposition and gave WindCatcher a run for its money.  The project was eventually cancelled when Texas failed to approve its costs being charged to ratepayers.  However, Invenergy sort of jumped the gun on the wind farm part of the project and began minimal construction in order to preserve its federal tax credits for the project.  After WindCatcher was cancelled, Invenergy found itself with a stranded, partly constructed wind farm that it couldn't connect.  Like all creepy critters, Invenergy crawled back under the baseboard and waited patiently until opportunity was ripe to give it another go.

Invenergy and NextEra were finally rewarded for their patience by the current administration's tax money giveaway to anything with "clean" or "transmission" in its name.  The time to strike is now.

Word has it that NextEra is approaching landowners to get permission to survey for a 500-mile extra high voltage transmission line from Texas/Cimarron Counties to Muskogee/Sequoia Counties, and other areas in the southeast.  (Check a map... it's only 400 miles from the panhandle to Muskogee, at best.  Where is this line really going?).  The route of NextEra's new transmission project sounds almost exactly the same as Clean Line's route through Oklahoma.  NextEra has kept its cards extremely close to the vest, avoiding any media or online presence.  Maybe it's hoping nobody finds out about it yet?  NextEra is certainly not being transparent about its plan and that doesn't bode well for affected landowners and communities.

Invenergy has recently put out its own feelers in a much more public way to build what it's calling the Cimarron Link transmission line.  This transmission project proposes a route from Texas/Cimarron Counties to a substation near Jenks, which almost exactly matches AEP/PSO's WindCatcher route.  Invenergy claims it is reaching out to landowners to negotiate easements.

As if the people of Oklahoma along these very same routes haven't already played this game with either Clean Line or PSO.  There's a thing called "transmission fatigue" which describes a group of landowners who have already battled one transmission line on their properties and are experienced enough to do it again.  No real utility would stupidly try to use the same failed route for another project.  It's like trying to roll a ball uphill.

Do we really NEED two nearly identical transmission lines from the Oklahoma panhandle to the eastern part of the state?  These projects will run more or less parallel within 50 miles of each other.  How many turbines could they realistically build in the panhandle?  Are both sets of these transmission lines and wind farms needed, or will landowners pop some corn and sit back watching these two energy conglomerates from other states duel to the death in order to claim the panhandle?  I wouldn't even think of signing up with either one of them until they finish their duel.
0 Comments

The Emperor Has No Clothes

7/8/2023

1 Comment


Initial briefs have been filed in the Missouri Public Service Commission proceeding regarding the amendment of Grain Belt's Certificate of Convenience and Necessity.  I know some of us had a hard time staying awake for all 40 hours of the hearing, but imagine if it was your job to sum it all up as concisely and convincingly as possible, and get it all written in less than 30 days.  Brief writing isn't for the faint of heart.  In addition to exceptional writing skills, the lawyer has to frame it all within the parameters of precedent (the Tartan factors.)  I've read a lot of briefs over the past 15 years, and actually had to write a generous handful.  It's painstaking, tedious work that shuts out the rest of the world while you're doing it.

So, who did the best job briefing the GBE case?  Hands down the best brief was written by the Missouri Landowners Alliance attorney, Paul Agathen.  Legal briefs, by their very nature, can be very dry, boring and sleep inducing.  The rare brief that adds a little personality and common humanity is a gem.  Especially when it is extremely persuasive and opens new trains of thought.

One such nugget I gleaned from the MLA brief is that perhaps GBE is trying just a bit too hard.  Since GBE's application is for an amendment to its existing CCN, the only thing it needed to prove was that the amendments were needed and in the public interest.  GBE did not need to re-prove the general need for the project or its benefits.  But that's exactly what GBE did (and continues to do on brief), creating a blizzard of words designed to obscure the fact that there IS NO NEED for the amendments.  The most GBE could say is that Missouri would receive benefits "sooner" than it otherwise would by about 18 months.  That just doesn't add up against the huge expense of this proceeding to the PSC, Invenergy and all the other parties to the case.  They probably spent more than any supposed early "benefits."  A thinking person might suspect that there's an ulterior motive behind all this, and the possibilities are endless.  I won't detail them all here... that's another blog.  Just remember... if it doesn't ring true, it simply isn't.  Let's hope the PSC thinks long and hard on this simple fact.

Here's a few delicious snippets from the MLA brief that everyone can understand:
Grain Belt is also in the process of shifting some of the risk of the project to taxpayers, through its application to the DOE for a loan guarantee for a substantial portion of the construction costs.  And by shifting a portion of the risk of the project to taxpayers, Grain Belt will no longer be bearing all of its risks – raising the question of whether it is still are a merchant project.
Ya know, perhaps Brad Pnazek was right when he "misspoke" at the DOE webinar... Grain Belt Express is not a merchant transmission project.  It's all snuggled up to the government teat and is preparing to feast.  Will the DOE require that GBE have signed contracts representing an adequate revenue stream before signing the loan guarantee?  Or will the DOE obligate taxpayers to pay for GBE without adequate consideration of whether or not GBE can repay?  While GBE tells the MO PSC that it cannot get financing without enough firm revenue to support the loan, is that really true if it gets a loan guarantee from the DOE?  What if DOE loans them the money without any firm revenue?  Then it doesn't matter what the MO PSC CCN requires, GBE could build its project without any contracts at all and then walk away on a half-finished project if actual contracts don't materialize by the time they run out of borrowed money.  Don't make me say "I told you so."
Under the terms of the FERC order which initially granted Grain Belt the authority to negotiate rates with its customers, Grain Belt is required to solicit potential buyers of capacity through what is called an “open solicitation” process.  Grain Belt began the customer solicitation process in January of 2015 – more than 8 and a half years ago.  Yet despite its concerted efforts to do so, since that time Grain Belt has failed to sell a single MW of capacity at market rates.
Yes... GBE's negotiated rate authority from FERC requires the company to hold an open season for all available capacity and to negotiate fairly with all interested customers.  Once an open season closes, the company is stuck negotiating with the parties who expressed interest.  It may not expand its pool of potential customers without opening a new open season.  Is GBE still negotiating with the original interested parties from 2015?  I doubt it.  Also, when capacity expands, the company is required to re-notice the open season for the additional capacity.  Did GBE do this?  I doubt it.  Finally, the PSC should take note that GBE's negotiated rate authority does not allow the company to sell "undivided interests" in the project instead of capacity.

And on the subject of GBE's potential customers, there's this nugget that demonstrates GBE's puffery about having customers.
Grain Belt’s lack of success is certainly not due to a lack of trying. After the close of the previous CCN case, Grain Belt has been actively seeking, although unsuccessfully, to sell capacity on its line at a sustainable rate.

At one
point Grain Belt had signed Memorandums of Understanding (MOUs) with three entities for the sale of capacity on the Project.  But the period for further good faith negotiations regarding each of those MOUs has now expired.  Therefore, those parties have no obligation to buy anything from Grain Belt or to even engage in future negotiations with Grain Belt.  In addition, Grain Belt signed a Letter of Intent with another party regarding the sale of an interest in the Project, but the commercial terms of that proposal had not even been disclosed by Grain Belt to the counter-party at the time the testimony was filed in this case.  Thus at this point, the Letter of Intent is at best nothing more than a non-binding MOU.  Also, last year Grain Belt submitted proposals to four utilities for the sale of varying interests in the Project.  Apparently, none of those utilities has accepted or even formally responded to Grain Belt’s proposed sales.
Well, there you have it.  Grain Belt seems to have a scary lack of success finding any customers.  Could it be that the bloated, costly GBE project is not attractive to customers at market rates?  It certainly appears so to me.  Pretending that GBE has no market rate customers only because it does not have all its permits just doesn't hold up under logical scrutiny.
In summary, despite its on-going efforts to do so, Grain Belt has failed for nine years now to sell even a single MW of capacity at a sustainable rate. Yet they continue to hope that if they build the Project, the customers will come.  Given Grain Belt’s track record over these past nine years, it is time to recognize that the emperor has no clothes.
That's right... naked as a jay bird.
Invenergy recently filed a formal complaint with the FERC against MISO regarding the way MISO treats the Grain Belt Project in MISO’s long-term transmission planning process.

Briefly, Invenergy’s complaint is that MISO does not include the Grain Belt project in MISO’s “base case” in its yearly evaluation of what additional transmission projects MISO should add.

Invenergy no dou
bt knows exactly what it was doing in filing the complaint case against MISO. If it is successful, its efforts in that proceeding could prevent MISO from pursuing alternative transmission service that could duplicate Grain Belt’s Project. If Grain Belt is attempting to eliminate competition from the MISO projects, it is fair to ask how confident Grain Belt could be in its own financial viability.
Bingo!  Eliminating competition is the only logical reason for Invenergy to have filed that complaint at FERC asking that MISO toss out its transmission plan approved last year and add GBE so that competing projects bringing wind from Iowa to Missouri won't be built.  Afraid of a little healthy competition, are we?  Is that any way for a market-based merchant transmission line to behave?  Sounds suspiciously like an attempt at market manipulation.
Grain Belt contends that its investors bear the risk of the Project.  However, as Staff has observed, “Invenergy has repeatedly petitioned FERC to require RTOs to pay for the presumed benefits of this and other merchant HVDC projects, which could result in Missouri ratepayers paying for the project regardless of use by Missouri Utilities.”
Right.  Finding another source of income because GBE just can't cut it as a merchant?  When the naked emperor is exposed, who is going to be left picking up the pieces on this Franken-project?  Ratepayers?  Taxpayers?  Landowners?  Remember how Solyndra spent $500M of taxpayers' money building their wonder factory, but in the end walked away without a scratch?  GBE is Solyndra 2.0.
On the issue of financial viability, Grain Belt has apparently recognized a need for additional revenue sources in order to bolster the viability of its Project.  Until now, GrainBelt’s revenue was to be derived solely from the sale of capacity on the line.  Now, as another means to raise revenue, Grain Belt is also offering to sell or lease an undivided interest in the ownership of the line itself.

M
s. Shine stated that the undivided interests would be a sale for the exclusive use of the line by the purchaser.  However, exclusive use is not a public use. While the issue is not ripe for a decision in this case, if Grain Belt sells undivided interests for all or a significant portion of the Project, the MLA contends Grain Belt would no longer be a “public utility” or serve a “public use.”
This is perhaps one of the biggest issues -- if GBE does not offer its service for public use, is it still a public utility with eminent domain authority?  What if GBE sold an "undivided interest" for 99% of the project's capacity to another Invenergy affiliate that owned generation at the Kansas end of the line?  Perhaps the nation's largest wind farm planned by Invenergy CEO Michael Polsky?  If Invenergy applied to the MO PSC to build a generation tie line for its own exclusive use across Missouri, would the PSC grant them public utility status?  The answer is, most likely, no.  So why should the PSC allow this exact thing to happen via a back door?  The PSC should consider ALL the new evidence submitted, even if GBE doesn't want them to look.  I think GBE is no longer a merchant transmission project, nor a public utility.

Coming up next... reply briefs.  I think we can expect more of the same.
1 Comment
