StopPATH WV
  • News
  • StopPATH WV Blog
  • FAQ
  • Events
  • Fundraisers
  • Make a Donation
  • Landowner Resources
  • About PATH
  • Get Involved
  • Commercials
  • Links
  • About Us
  • Contact

Invenergy Finally Admits It's Not Building Clean Line's Grain Belt Express

8/26/2020

0 Comments


Nudge, nudge, nudge... did it get a little hot under that magnifying glass, Invenergy?  Seems like Invenergy rushed its gush just a little bit yesterday, because it just doesn't make sense.  There are still crucial parts missing.  However, the fake news corporate-controlled media probably won't notice because they are no more than well-trained parrots anymore.  They don't know, and don't care, whether the "news" they report makes sense... they just re-print glossy press releases as if they mean something.

The media has never understood, and fails to understand now, that GBE is just a transmission line without enough customers to make it feasible.  GBE does not sell electricity, wind powered or otherwise.  It is nothing more than a toll road.  So when Invenergy and the media gush on about how much a transmission line will save consumers, it's complete and utter garbage.  Without the wind farms built and in operation (and they're not, not even on any planning list) nobody knows how much the power would cost, it's nothing but a guess.  As well, nobody knows how much the transmission line is going to cost consumers.  The rates GBE will charge its VOLUNTARY customers are still to be negotiated.  If the rates negotiated with customers who so far don't exist are high, so are the costs consumers will pay to use the transmission line.  If the rates negotiated in the future are low, then costs consumers pay to use it will be low.  GBE has NO IDEA how much it will charge its customers to use the transmission line in the future, but it's a given that GBE will try to charge the highest prices it can negotiate.

GBE only has ONE rate scheme.  It has been authorized to negotiate with voluntary customers to sell service on an open-access transmission line under FERC rules.  It has no state rate mechanism where it can add its costs to the rates captive electric customers pay.  Saying that Grain Belt Express + some vague generation that doesn't exist will save the citizens of Missouri up to $50 per month on their electric bill is nothing more than a shell game.  It's just guessing.  GBE's "report" from a hired consultant is nothing more than speculative garbage.  It tries to sound all scientific, but it actually says nothing more than... "We created an equation that produced this number.  We can't let you see the actual equation, or the actual data we used, or the variables we tossed in, but just trust us on this one.  Our answer is valid!"

Oh, please!

Unless, it's not an open-access merchant transmission line selling capacity at negotiated rates, but instead the GEN-TIE Beth Conley mentioned.  A gen-tie would combine Invenergy's generation with Grain Belt Express and sell buyers generation delivered to eastern Kansas or Missouri, instead of just transmission service (plus a contract for generation that would have to be negotiated with a third party).  That would look sort of like this statement:
The transmission line and associated wind generation (collectively referred to as “Grain Belt Express” or “Grain Belt”) are projected to create significant cost savings for electricity ratepayers in Kansas and Missouri.
Who is going to buy this service or product?  Grain Belt Express has been trying to sell 500 MW of transmission service to Missouri since like 2014, and has only managed to sell "up to 200 MW" to MJMEUC at a loss leader price.  During PSC hearings, project owners said they would make up for the below-cost price MJMEUC was paying by selling service from Missouri to Indiana and charging more for it to make up the difference.  Without the leg to Indiana, who is going to pay more than their share to support MJMEUC's sweet deal discount?  And if GBE had so much difficulty selling "up to" 200 MW of its offered 500 MW of service in Missouri that they had to reduce it to sell at less than it costs GBE to provide the service, who is going to buy the other 300 MW of service to Missouri, much less the additional 2,000 MW Invenergy now says it's offering to Missouri customers.... and pay way above cost of service for it?

And what happens if Invenergy dumps 2,500 MW of imported wind energy from Kansas (or other places, like Oklahoma - google "States Edge Wind") into Missouri's electric grid?  That's 2,500 MW of electricity currently produced in Missouri that will be supplanted by a variable source produced in another state.  That's more power than produced by Missouri's largest electric power plant -- no longer needed by Missourians to keep their lights on.  Will Missouri's electric generators be closed, causing massive unemployment and loss of tax dollars for the communities where they are located?  Did Invenergy figure that into it's phony equation?  And how much harder will the surviving electric generators have to work to cycle up and down to support such a large variable resource to make sure the grid's delicate balance is maintained?  Missouri needs to think long and hard about importing such a large amount of variable power, and sending its energy dollars to Kansas and Chicago.  When power produced in Missouri is used in Missouri, the economic boost and energy dollars stay in Missouri.  Supporting economic development in Kansas does NOT fix Missouri's economy!  The nonsense Invenergy is spouting simply doesn't make sense.

And what about Illinois?  Invenergy is pretending it ran into some sort of regulatory snafu there and that's what spurred this sudden change.  There's absolutely no evidence that Invenergy ever applied for a permit in Illinois!  And the one Clean Line obtained was cancelled by the ICC at the direction of the Appeals Court.  Invenergy would have to start from scratch by filing a new application for a permit before it could run into any regulatory snafus.  Invenergy's snafu seems to be of it's own creation by failing to actually file anything in the first place.

And speaking of regulatory filings and state permits...  Invenergy informs that it's going to have to apply to both Kansas and Missouri to make changes to its current permits.  What if one or both states require completely new applications for this completely new project?  This isn't the Grain Belt Express approved by Kansas or Missouri.  It's a completely NEW project that has simply appropriated GBE's name and a portion of its route.  It's a completely new project for a completely new purpose owned by a completely new company.  It deserves to be subject to a completely new state review.  So much has changed that relying on existing information under the guise that this is still the same project is nothing less than lying by omission.
And, hey, guess what?  If Invenergy's permits are no longer valid because they're no longer building the project they had permitted, then Invenergy/GBE no longer has eminent domain authority!  No reason for landowners to even acknowledge GBE land agents that have been calling.  GBE/Invenergy CANNOT take your land until it receives new or updated permits.

Way to win community support, Invenergy!  Now people probably think Invenergy is an even bigger liar than Clean Line Energy Partners ever was.  And the truth is still missing!
0 Comments

PA OCA Recommends Denial of Transource Project

8/22/2020

1 Comment


Ut-oh, Transource!  UTTT-OHHHH!  It's looking like the smoke and mirrors Transource and PJM have been using to prop up their unneeded Independence Energy Connection project didn't fool the Pennsylvania Office of the Consumer Advocate.  In fact, it looks like PJM and Transource didn't manage to fool anyone... anyone at all.

Finally got around to looking at the initial briefs in the PA-PUC proceeding, and I recommend the OCA's extensive brief for some great reading!  I have to admit that I didn't bother to even look at Transource's brief.  There was no need after I read the OCA's.  I'm convinced there's simply nothing Transource can say that would be even remotely convincing about a need for this project.  And it's Saturday... why torture myself even further?

The OCA says
The OCA submits, however, that this market efficiency project designed to address economic congestion on the bulk electric grid cannot meet the constitutional, statutory, and regulatory standards under Pennsylvania law. Under the evidence presented, actual congestion on the AP South Reactive Interface has diminished precipitously in the years since this proceeding began, subverting any reason to construct this Project. Moreover, PJM’s benefit-cost analysis, which the Company relies upon to allege that this Project will provide sufficient benefits in excess of the costs, contains significant deficiencies such that it cannot support the necessary findings under Pennsylvania law. Most importantly, PJM’s benefit-cost analysis ignores the detrimental impacts of increased wholesale power prices that accrue to certain transmission zones as a result of constructing the IEC Project, including many transmission zones in Pennsylvania seeing increased costs for Pennsylvania ratepayers. In addition, PJM’s process for approving the IEC Project failed to consider reasonable alternatives and did not address the serious environmental and property issues raised.
And
... the Commission should not approve the IEC Project based upon the Company’s claims of potential reliability violations occurring in 2023 in the absence of the IEC Project. The Company’s belatedly filed evidence is based upon limited testing and outdated data. Moreover, the facilities that may experience these potential violations are aging facilities that are due for an upgrade in the coming years. Indeed, since 2018, several of the facilities that the Company claims will overload are undergoing rebuilds that may increase capacity. The OCA submits that if the IEC Project is not approved, PJM has the means to determine if these potential future reliability violations will still occur and find more efficient, targeted proposals to correct these issues.
And
... Pennsylvania would also be burdened by new transmission infrastructure construction in Franklin and York Counties, including a new substation and a new transmission line in Franklin County, 13.6 miles of which will be constructed over presently unencumbered land, and lengthy re-builds of additional transmission infrastructure and a new substation in York county. Accordingly, these economic and environmental harms demonstrate that the IEC Project fails to meet the constitutional, statutory, and regulatory standards under Pennsylvania law.
And for these reasons
For the reasons set forth herein, the Commission should deny the Company’s Applications.
The company, with the help of IEC proponent PJM Interconnection, has completely failed to demonstrate need for the IEC.  PJM has dug itself a real pit trying to dart and weave in order to bolster its continually failing justification for the IEC.  PJM should have cut its losses and moved on long ago.  But for some reason, PJM prefers to make up new numbers, change its processes, and engage in a general course of "magic math" endeavors to dig deeper and deeper into the realm of unreality in order to support a project that may have been a good idea once upon a time but has since become obsolete.  This is nothing new... once PJM orders a project to be built it holds onto that project way beyond reason and will do immoral things to support the project's necessity.  This does not serve ratepayers.  This serves PJM's member transmission owners who stand to profit from building new transmission we just don't need.

According to PJM, the IEC would provide $844M of benefit over the first 15 years.  The OCA's witness calculated that the IEC would also produce an unaccounted for increase in the cost of power in Pennsylvania by an estimated $812M during that same period.  These two numbers must offset themselves, leaving a mere $32.5M of benefit for PJM consumers over the first 15 years of the project.  To realize that $32.5M in benefit, PJM consumers must spend $527M over the same time period.  This creates a benefit/cost ratio of 0.06.  This means that for every dollar ratepayers pay for this project, they will receive 6 cents of benefit.  As the OCA witness pointed out, this makes no sense.
...I reached the same conclusions whether we look only at Pennsylvania or whether we look at PJM as a whole. Either way this project makes no sense. You don't spend 350 or $400 million so you can save $12 million over a 15-year period. It makes no sense. Q. Only under your cost-benefit analysis; is that right?
A. Under any logical view of what's happening. If you build this project, you can save utilities in Maryland, Virginia, and the District of Columbia almost a billion dollars over 15 years; and, if you don't build that project, that same power is going to be used in Pennsylvania, Ohio, Illinois, and New Jersey at a cost of about $970 million.
So, yes, there is some congestion. There is a technical problem to be solved, and the value of that congestion as laid out in the most recent estimate we have is less than a million dollars a year over the next 15 years. So this project makes no sense. I don't care how you run the numbers or how you talk about it. Those are the latest numbers we have, and you can exclude them if you want to but that's reality.

Pennsylvanians are so fortunate to have a great consumer advocate!  The OCA's work on this case is most likely crucial to the ultimate outcome.  Let them know you appreciate their efforts!

Of course, it's not over until it's over.  There's probably another round of reply briefs to come, followed by the decision of the administrative law judge assigned to the case.  After that, parties may file further arguments for their position before the Commissioners vote on the matter.  Will the PUC Commissioners toss out all the work of the judge and approve this project on an unsupported whim?  That's going to be a whole lot harder to do, thanks to the OCA!
1 Comment

Did Beth Conley Just Let Invenergy's Cat Out Of The Bag?

8/21/2020

1 Comment


Miss Kitty Hamm doesn't play well with others.  She's always on the prowl for other cats invading her space.  She alerted me this morning to a strange cat in the vicinity.  We think it may be Invenergy's cat.  And what a tale this kitty has to share!

New this morning is a podcast from Energy Cast.  Take a listen.  On this podcast, Invenergy's vice president of communications, Beth Conley, says something incredibly curious.  If you listen really hard, you may hear some faint meowing and hissing as if someone is trying to stuff a cat back into a bag from which it has just escaped.

Around minute 17:05, this podcast gets really interesting.  Beth is telling the host about the other kinds of energy projects her company is working on.  She says
"We're looking at working on transmission for gen-tie"
And then the audio gets abruptly cut off, as if Beth's power supply was cut, or maybe something was edited out, or she suddenly found her foot in her mouth.  There's a definite blip in the audio when she mentions the word "gen-tie."  She picks back up in mid-sentence, stating
"... for some of our existing projects and then as stand alone projects recognizing that renewables are located often far from demand."
Gen-tie?  Did she mention gen-tie?  Yes, yes, she did!

What's a gen-tie?  It's short for "generation tie line" also known as "Interconnection Customer's Interconnection Facilities" (ICIF).  A gen-tie is a generation company's private driveway to a strong point on the transmission system where it's feasible to connect their generator.  A gen-tie is not a public use, open-access transmission project that others can use to ship energy at set rates.  An ICIF owner is not required to let others connect and use its line... all the capacity on an ICIF line is for the exclusive use of the owner's generation.  There are no rates others pay to use these lines, because others cannot use these lines.  A gen-tie is a private use facility paid for and used exclusively by its owner.  These facilities are protected from having to supply transmission service to others.

So, Invenergy is working on a transmission gen-tie ... for some of their existing projects, and then as stand-alone projects... but they are still gen-tie facilities, and not open access transmission lines.

Where might Invenergy be working on a transmission gen-tie project?  Look it up on google.  I can't really find any.  Can you?

However, Invenergy is working on the Grain Belt Express transmission project.  But that's not supposed to be a gen-tie project.  It's a merchant transmission project that is supposed to sell transmission capacity to unaffiliated companies at negotiated rates.  Anyone who wants to take service on GBE can make Invenergy an offer... or maybe they could, if Invenergy was actually holding an open season looking for customers.  But google can't find that either.  If Invenergy is selling service on GBE, it's a deep dark secret... and open seasons are not supposed to be deep dark secrets, but widely publicized to draw maximum notice from potential customers... just to be fair and all.  If Invenergy was selling service to the highest bidder, wouldn't it be fair to give everyone an opportunity to bid?

Of course, if GBE was a gen-tie, there is no public notice necessary because no one else can buy service on the line.  Deep-dark-secrets are okay here!

Does it make a difference what Invenergy is building?  Of course it does!  The Missouri PSC and the Kansas KCC issued permits to build a merchant transmission project and granted eminent domain authority for Invenergy to take rights-of-way for GBE.  Both states considered GBE a "public use" transmission project worthy of eminent domain authority because it was selling service to other customers for benefit of the public at large.  A gen-tie does not provide public benefit... it only provides benefit to its owner... like a private driveway vs. a public roadway.  We can all use public roadways, but we cannot use private driveways belonging to others for our own profit.

What exactly is Invenergy building now?  If it says it's building a merchant project for sale at negotiated rates, then it can use eminent domain to acquire property, or at least the threat of it, to push landowners to sell.  If it's building a gen-tie, it probably wouldn't be allowed to use eminent domain to acquire property and would have to pay whatever price landowners demanded for right-of-way.  Without the sledgehammer of eminent domain, market prices depend on arms-length negotiation and no landowner is forced to sell an easement.

Don't you think Invenergy should start practicing some of that great "transparency" Beth tootled on about during the podcast?  Maybe landowners should start asking Invenergy representatives if GBE is a gen-tie, generation tie line, Interconnection Customer's Interconnection Facility, or ICIF?  And maybe they should record Invenergy's answer, or get it in writing?
Down, Miss Kitty Hamm, down!  Does anyone have some catnip I can borrow?
1 Comment

Caveat Venditor, Missouri!

8/14/2020

0 Comments


Seller beware!

Landowners along the proposed GBE route have found it necessary to file two separate complaints at the Missouri Public Service Commission regarding the behavior of GBE and its land agents as they bombard landowners with requests to "negotiate."  Grain Belt Express seems to be in a great big hurry but perhaps the landowners aren't buying the slick, carnival spiel.  You've got to get up pretty early in the morning to fool a farmer!  Perhaps Invenergy missed all the earlier Mayberry lessons?

The first complaint, filed on June 22, reveals that a GBE land agent calling a landowner on the phone stated,
“Grain Belt is no longer involved with this business” (or possibly, that “Grain Belt is no longer involved with the business.”)
It was a strange one-off until a second landowner got a similar call from the same GBE agent who made similar statements.
Based on statements made during those telephone conversations by the two CLS agents, Mr. Daniel was also led to believe that Grain Belt was no longer associated with the proposed transmission line project.
Now it's a pattern involving one particular land agent.  Was lying to landowners about who owns GBE, or possibly the name of the project, working for this land agent?  Was it getting his figurative foot in the door?  But it's dishonest!  It's against the GBE Code of Conduct for Land Agents that's on file at the PSC.

However, Invenergy's attorneys denied it ever happened and filed an affidavit from the land agent denying ever saying anything like that.  Who believes a liar?  The landowner reported that the land agent told him a lie... so why wouldn't the land agent tell the PSC another lie?  You know what happens when you lie... one little lie leads to other lies to cover up the original lie, and the next thing you know everything is a lie... and then you're just a liar.

What a coincidence -- a land agent is accused of saying something that dovetails nicely with Invenergy's current attempt to publicly wash its hands of the GBE name and make landowners believe it's something different.  Why else would Invenergy use door hangers that say "under new ownership"?  And why would they be purchasing country hams in the name of "Invenergy Transmission" instead of Grain Belt Express?  Invenergy's efforts to shed GBE's bad juju have been numerous.  Lying to landowners could be just one more manifestation.

Landowners aren't falling for this crap, are they?

So, the PSC will investigate.  Or something.

A second landowner complaint was filed just this week.  This complaint comes from a landowner who noticed differences between the standard easement that Clean Line used that was approved by the PSC, and a new standard easement sent to him by a new GBE land agent.  This new easement form has NOT been approved by the PSC and may not be in the landowner's best interest.  Items that changed:
  • Section 26 of the revised easement introduces an entirely new provision, titled “Waiver of Jury Trial”. Printed in all caps, so as to highlight its obvious importance, this section essentially provides that if there is any unresolved dispute regarding any provision of the easement agreement, the parties automatically forfeit their right to settle the issue in a jury trial.
  • Section 21 of the revised easement includes another new concept, under the heading of “Severability.” It essentially states that if any provision of the easement is found to be invalid, the remaining provisions of the document shall remain in full force and effect. There was no similar language in the original easement.
  • Section 23 of the revised easement, mentioned in the preceding subsection, attempts to protect Grain Belt from legal defects in a document which was drafted (or at least approved) by the Respondents themselves. It would force the landowner to join with Grain Belt in correcting such defects by either amending the easement or signing a new easement in a form reasonably requested by Grain Belt.
  • Section 2.e of the revised easement, titled “Site Plan”, could seemingly have the landowner signing the easement as tendered without even knowing the type and number of support structures, if any, which would be installed on his or her property. The “approximate location” of the structures, as referred to in Section 2.e, may or may not mean that those structures will eventually be built on any particular parcel of land. And without that information, the landowner cannot determine what the total easement payment will be, and thus cannot logically decide whether or not the proposed easement is in their best interest.
  • Section 8 of the revised easement, titled “Cooperation”, seemingly gives Grain Belt the right to sign documents in the landowner’s name, without the landowner even knowing the specific language in the document being signed.
  • Section 22 of the revised easement is also new. It provides that the activities of both parties shall be controlled by the Missouri Landowner Protocol, Missouri Agricultural Impact Mitigation Protocol, and the Code of Conduct -- “as may be amended, supplemented or replaced from time to time....” Based on this quoted language, Grain Belt has apparently given itself the unilateral right at any point in time to revise or replace any of the documents in question. And those revisions would presumably constitute binding provisions of the easement.
  • Under Section 10 of the original easement agreement, Grain Belt was generally given 30 days to cure any monetary breach of the agreement before it could be terminated by the property owner. Under Section 12 of the revised agreement, that period has been extended to 60 days. This change is significant, in that it could allow Grain Belt to salvage an easement which could otherwise be terminated. If 30 days was sufficient during the entire course of the CCN proceedings, there is no reason to believe that is still not the case.
  • In Exhibit C to the new agreement, Grain Belt grants itself a three year Easement Agreement Extension, as opposed to the two years specified in the original easement.  Again, this is simply another example of Grain Belt’s attempt to unilaterally modify the terms of this important document to its own advantage.
  • The Missouri Landowner Protocol, compliance with which is mandatory on Grain Belt’s part, provides in part as follows:  Grain Belt Express will pay landowners for any agricultural-related impacts (“Agricultural Impact Payments”) resulting from the construction, maintenance or operation of the Project, regardless of when they occur and without any cap on the amount of such damages. For example, if the landowner experiences a loss in crop yields that is attributed to the operation of the Project, then Grain Belt Express will pay the value of such loss in yield for so long as such losses occur. In other words, the intent is that the landowner be made whole for any damages or losses that occur as a result of the Project for so long as the Project is in operation.  This language clearly means, for example, that Grain Belt would be responsible for crop damages resulting from soil compaction anywhere on the property for as many years as those damages continue. The same would be true for crop losses resulting from damages to drainage systems.  Crop damages are addressed in Section 3 of the revised easement agreement, which is at best confusing. It first echoes the general principles quoted above from the Landowner Protocol. However, it goes on to state that the compensation as computed in Exhibit E to the revised easement “is in satisfaction of all loss in crop yields attributed to construction of the Facilities ... throughout the Term of this Agreement and Grantor [the landowner] waives all additional claims for loss in crop yields associated with such construction ....”  So one must look to Exhibit E to determine if it preserves all of the rights to compensation provided for in the Landowner Protocol. At best the answer is unclear. At worst, the revised easement can be read as eliminating a potentially significant portion of the compensation for crop damage required under the Landowner Protocol.
  • As is apparent, Section 3 and Exhibit E of the revised easement either totally confuse the issue of crop compensation, or more likely, they would act to reduce by potentially significant amounts the actual compensation to which landowners are entitled under the provisions of the Landowner Protocol. In either case, those provisions of the revised easement agreement should be eliminated.
  • Section 6 of the original easement states that if the easement is terminated by Grain Belt, it must remove its facilities within 180 days of the termination. Under Section 11 of the revised agreement, Grain Belt would only be required to remove the facilities “as soon as practicable”.
  • Section 13a requires that if someone purchases the land on which an easement has been granted, the new owner is required to notify Grain Belt in a specific, detailed manner before Grain Belt is required to make any payments to the new property owner. No such provision was included in the original easement, and nothing has occurred in the interim which would warrant this more stringent notification process.
  • Section 2 of the original easement refers to the grant as being “a perpetual exclusive agreement.” The comparable section in the revised easement does not specify that the easement is to be “perpetual”. This change could cause needless confusion not only on the part of landowners, but potentially in any future litigation related to the term of the easement. The original language should be reinstated.
  • Finally, Paragraph 2.d of the revised easement gives Grain Belt the right to use the property in question “for installation, operation, and maintenance of fiber optic cable ....” The problem here is that the CCN does not authorize the installation of fiber optic cable as part of the Grain Belt project.
That's a lot of changes.  Looks like Invenergy just did a wholesale re-writing of the easement agreement.  I'm pretty sure they didn't do it for the benefit of the seller.  Invenergy's lawyers work for Invenergy, not you.  Never sign anything without the advice of a lawyer who works for you!  The second complaint is the reason why.

Invenergy has reneged on a lot of Clean Line's promises about GBE, and not for the better.  Remember the monopoles?  Yup, gone.  All towers will be lattice.  They're cheaper to build, you know.  Spare no expense for the landowner who will be looking at it in perpetuity.  As well, the name "Grain Belt Express" has become a dirty word best not mentioned in the hope that the landowner will forget to pick up all the old GBE baggage before negotiating.  Now the easement and other documents that the PSC thought provided a measure of safety to landowners have been tossed out the window and replaced with documents that give Invenergy more rights and landowners less compensation.

What else has changed?  Don't you think it's time for Invenergy to come clean about exactly what it thinks it's building now?  It's not Clean Line's Grain Belt Express.  What if landowners refuse to negotiate until they have answers?

Caveat Venditor, Missouri!
0 Comments

Big Wind's Big Bucks Bandwagon

8/12/2020

1 Comment


How obviously greedy does a wind turbine company have to be before a supposedly "clean energy" website poops all over their poorly written blog post?  That's what I wondered when I came across this "article" on CleanTechnica.  CleanTechnica is pretty famous in certain circles for its misinformed pandering to an arrogant bunch of sycophantic loyalists who post incessant, incorrect "facts" and argue with people in the "article" comments.

So, I went looking for the source, although CleanTechnica conveniently "forgot" to link to its source material, it was easy enough to find.

It looks like this guy is the "president of sales" so of course he's interested in selling more product, in this case wind turbines.  I hope he's better at selling wind turbines and he is at selling ideas, because this one is dead on arrival.  Even CleanTechnica couldn't stomach it.

Chris's main problem seems to be that there's not enough transmission from the remote areas where his customers would put his wind turbines.  This is cramping Chris's profits (and probably his bonus).  So now Chris is an expert on electric transmission and has all the good ideas that nobody has ever tried before.  And he deploys it using the most trite of propaganda devices.

The Bandwagon propaganda device attempts to persuade the target that everyone else thinks the same way as the propagandist.  Use of inclusive words and ideas, such as "everyone", "we", "our", or "most Americans" are a way the propagandist draws the reader in to think that if they don't agree with "everyone" and conform, they're missing the bandwagon and will be left out or become unpopular.  It replaces individual thought with group think.  And there's nothing more dangerous to personal liberty than mob rule.
Find the use of bandwagon in this short quote:
Every week you open your browser, scan the headlines, and see something to the effect of, “fossil fuels are out and clean energy is in”. The recent court decision upholding the shutdown of the Dakota Access Pipeline and Dominion and Duke’s decision to abandon their Atlantic Coast pipeline project indicate a changing tide in how consumers and utilities view our energy future.

Most Americans want clean energy. People want electric vehicles and a cleaner environment. But, our policies on building the infrastructure to deliver this clean energy future have not caught up to public sentiment.

In June, the leading renewable energy trade associations made a goal to reach 50% renewable energy by 2030. Meanwhile, if elected, Joe Biden will push for a carbon-free power sector by 2035. Goals aside, the fact remains we need more transmission to move cheap wind and solar from more rural areas to load centers if we want to reach ambitious clean energy goals. We need a new wave of electron pipelines.

Not me.  Chris doesn't speak for me.  He probably doesn't speak for you either.  You know who he speaks for?  Vestas and himself.  But yet he has imposed his personal and business views on "most Americans", "you" (the reader), "consumers", "utilities", "people", "public sentiment", "we, we, we" (all the way home!) for the express purpose of convincing someone that his ideas have merit.

Let's look at some of these ideas:
The Plains & Eastern transmission project exemplifies this problem. In 2009, Clean Line Energy Partners announced plans for a transmission line that would carry 4,000 MW of clean power from Oklahoma to load centers in the southeast and Mid-Atlantic. Years of navigating state and local regulations and gathering, then losing, federal support ensued.

By 2019, Clean Line had divested most of their transmission projects, including the Plains & Eastern Clean Line project, selling them off with the hopes someone else could overcome the endless regulatory and political battles associated with interstate transmission lines.

It NEVER had the support of its desired government customer, Tennessee Valley Authority.  It had hopes and dreams and a MOU that TVA would consider the project.  Ultimately, when TVA considered it, TVA decided Clean Line wasn't economic or needed for serving its customers.  Meanwhile, Clean Line could not find any other customers.  If TVA wasn't buying or was dragging its feet, Clean Line was free to go sell service to other eager customers.  Except there weren't any.  There were no utilities interested in buying service on a "clean line" from Oklahoma.  This is what ultimately killed the Plains & Eastern.  Get your facts straight, Chris!

And here's the inconvenient truth Chris misses -- it's not lack of transmission connections that is preventing utilities in other states from buying remote wind.  Even when the transmission connection can be made, customers fail to materialize, as the lesson of Plains & Eastern demonstrates.  Why?  Because states want to develop their own renewables because development of new renewables bring economic development to the state.  Why send your energy dollars to Oklahoma when you can create new industry and new jobs in your own backyard?  Offshore wind is coming!  Onshore wind profiteers like Chris are nearly hysterical over it.

It's simply not true that if new transmission is built utilities will voluntarily elect to use it.  Building new transmission is an attempt to FORCE utilities in other states to purchase imported power.  The industry keeps bellowing (without support) that remote wind from the Midwest is "cheaper" than building renewables near coastal load.  But how cheap is it really when the cost of the generation is combined with the cost of hundreds of billions of dollars of new transmission?  Not so cheap anymore... and it provides no economic benefits to the importing states.  The only way to make imported generation "cheaper" is to allocate the cost of building new transmission for export  onto captive electric consumers who may not benefit, instead of the current requirement that the generator must pay its own costs to connect to the existing system.  This idea cannot work because it upends the long-held principle that beneficiary pays for utility costs.

Of course Chris has ideas because he can solve any problem!  Let's make "coordinated transmission working groups" to change the siting dynamic, "transmission NIMBYism" and community involvement.  You mean Interstate Transmission Line Sighting Compacts?  Yeah, that hasn't worked in 15 years.  Why?  Because no state wants to subject itself to mob rule of other states.  Just because Chris has suddenly found the interstate compact idea doesn't mean it can suddenly work.  It won't work.

Next idea...
In addition to state input, there should be back-stop federal authority when transmission projects reach an impasse. The 2005 Federal Power Act attempted to give FERC this authority, but the rule framework was convoluted and limited in scope, leading to several court challenges. Through a clearer and more definitive act of Congress, FERC can serve as the final decision-maker when a transmission project cannot garner all permits from state and local authorities, or the permitting process is delayed beyond a year.
If the majority of a transmission line’s route has received proper permits, but a small portion has been denied or delayed by regulatory challenges, a transmission developer should be able to bring the case before FERC for final adjudication.

To address the aesthetic concerns of high voltage transmission lines, policy-makers can consider tax incentives or direct pay reimbursements for companies that bury their power lines near residences and towns or work with communities to design more aesthetically-pleasing structures.
To aid in the clean energy future, these incentives should only be available to power lines that predominately transfer renewable energy. This would allow transmission developers to accommodate the very real concerns of citizens and not break the bank.

Again, you're 15 years too late for this party, Chris.  Backstop siting authority didn't work because it was plain usurpation of state authority.  And Chris has made it even dumber with his plan for FERC to sit as some state transmission permitting court of appeals.  FERC has no such authority to overrule state permitting decisions.  Various iterations of FERC and special interests have been begging Congress to give FERC siting and permitting authority over electric transmission for years, but it's never even gotten close to happening.  It's unlikely to happen now, when Congress is at its most dysfunctional.  States do not want to give up their authority to the federal government.  End of story.

Chris also needs to learn that there is no such thing as a "power line that predominately transfers renewable energy."  Power lines are open access... electrons from all generators get mixed up and there's no way to separate them.  A transmission line cannot prevent "dirty" generators from using its line.

So who is all this propaganda directed at?  Your elected representatives.  If your elected representatives don't hear from you, they may believe Chris's lie that "most Americans" want huge increases in their electric bills to pay for new transmission lines in their own backyard that they'll have to fight in Washington, D.C. before people who have never set foot in their communities.  Make sure your elected representative hears the truth from you today!
1 Comment

Building Community Trust

8/9/2020

1 Comment


That's an important part of any infrastructure project, and Invenergy has completely failed at the task.

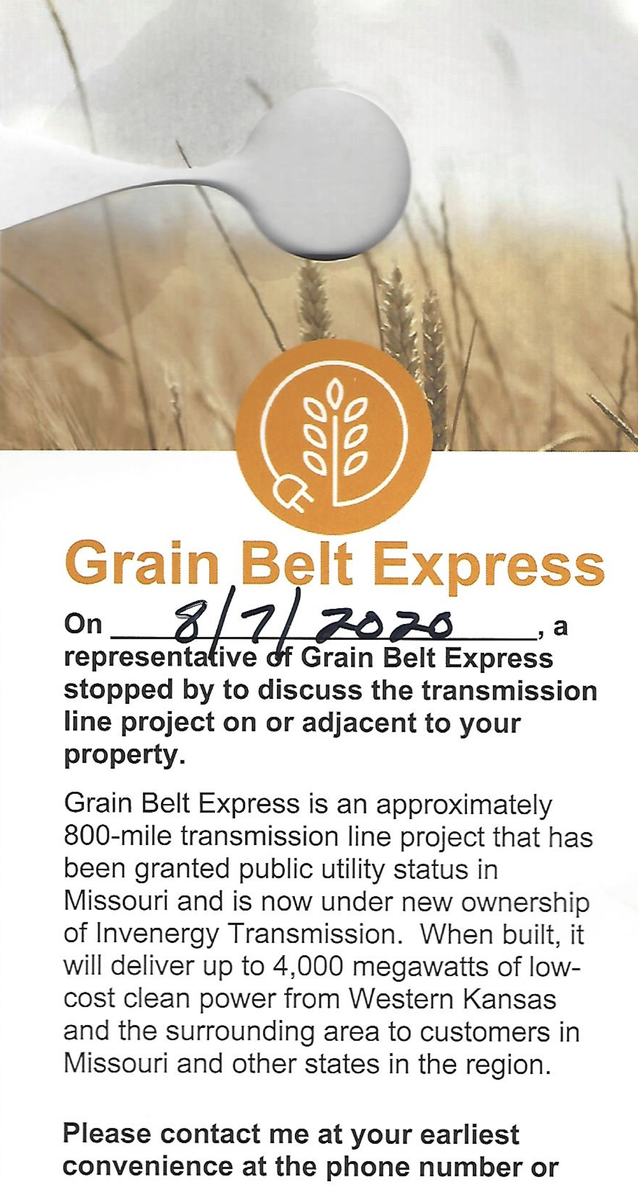

Behold!  An Invenergy/GBE door hanger left on a landowner's door.  Know where it ended up?  The trash can.  It had to be separated from the household refuse in order to sit for its recent photo session.  I'm going to guess that's a giant grease stain at the top, and not a weird, gray cloud.
And how does Invenergy attempt to build community trust with this door hanger?
NOW UNDER NEW OWNERSHIP!
Obviously, Invenergy understands that nobody trusted the prior owner of the project, Clean Line Energy Partners.  But simply stating there's a new owner doesn't get the job done.

Clean Line spent years holding community meetings and events with pulled pork sandwiches, bouncy houses, and other "fun" attractants for local residents to come and develop a cordial relationship with the company based on trust.  There was even a ham dinner, where one lucky landowner filled up his own sack with a pile of ham slices.  That event was so successful, it transformed an ordinary house cat into the amazing Miss Kitty Hamm, who is able to communicate through the internet for brief periods of time.
Unfortunately, like all cats, Miss Kitty Hamm has developed a little bit of an attitude.  She recently penned a note asking for more Grain Belt Express ham, but Invenergy is a cheap date.  It prefers to do ABSOLUTELY nothing to foster trust in the local community.  I tried to explain that there's little a company can do during these trying times.  There's a pandemic raging and person-to-person contact and sharing of food isn't a good idea.  But Miss Kitty Hamm can be incredibly stubborn...
Food is the key to a kitty's heart, however, the humans at Invenergy have underestimated the intellectual abilities of the average feline and the people who serve the cat kingdom.  We can read!  Where's the news stories?  Where's the colorful community advertising?  Where's the outdoor music festival where kitties and humans can cavort at a distance while enjoying music and speeches?  Where's the donations to food banks?  Where's the new parks being built for the communities?  Where's the cash donations to help the local schools with the added expense of distance learning?   Where's the catnip mice for the local animal shelter? There's plenty a "new owner" can do to win the hearts and minds of your average kitty.  Invenergy is failing to do anything to build trust with the communities in Missouri!  Without a pile of free ham, I simply cannot trust these people!
P.S.  That's not a grease stain.  My litter box needed changing.
The community's mistrust of Invenergy is raging.  First thing they did was eliminate Clean Line's proposed monopoles and replace them with cheaper and more invasive lattice structures.  Invenergy has not bothered contacting local county commissions to seek assent for its project.  Without assent, this project is not fully permitted.  And speaking of permits, Invenergy STILL has not bothered to submit an application for a permit in Illinois.  There's no end point for this project.  Where's the end point?  Well, Invenergy isn't saying.
Western Kansas and the surrounding area to customers in Missouri and other states in the region.
Well, that's sort of like dialing your binoculars out of focus, isn't it, Invenergy?  Clean Line's project used to go from Western Kansas to a substation in Indiana for delivery to eastern states.  But now Invenergy's project begins in "the surrounding area" of Western Kansas.  What "surrounds" Western Kansas?  Other states, like Oklahoma, where Invenergy owns the unfinished States Edge Wind Farm.  Other states like Colorado, Nebraska, New Mexico, and even Texas.  How many potential wind farms does Invenergy own in those states?  On the eastern end, what other states are in the same "region" as Missouri?  Illinois, Kentucky, Tennessee, Arkansas?  Where are the customers in those states?  How big is a state "region"?  Invenergy could be planning to build a transmission line through Missouri that begins and ends anywhere... or nowhere at all.  And since Invenergy is just so vague these days, should we ask ourselves who does that?  Who builds the middle of a highway to nowhere that doesn't connect with any known roads on either end?  You can bet that Invenergy has a plan... it's just not one it wants you to know about right now.  In fact, it appears that they don't want anyone to know about their actual plan right now, including regional transmission organizations, other utilities, and especially state regulators.  Not exactly a way to win your trust, is it, Kitty?
Meow!  Err... no.  I trust Invenergy about as much as I trust that smiling sadist at the veterinary clinic with the syrupy voice and greased fanny pole behind her back.
Trust in Grain Belt Express is at an all time low in Missouri.
UPDATE:  Ya know how Facebook spies on you and attempts to show you things you may like?  Miss Kitty Hamm hopes this means that Invenergy is planning another community ham dinner!  And sometimes the jokes just write themselves...
1 Comment

Holy Tesla's Ghost!  Wireless Transmission!

8/7/2020

0 Comments


A sprinkling of press this week about a trial in New Zealand for wireless electric transmission.

Sounds exciting, but after further study, it's nothing but a game of tradeoffs for affected landowners and communities.

Would you trade copper wire on gigantic towers for huge antennas on gigantic towers?  I can't honestly say which is preferable.  In addition, the technology only works when it has a clear line of sight between transmitter relays.  That means no obstructions along the path of the transmission --  no buildings, no hills, no vegetation.  Not only are they going to have to put these closer together to get around obstacles, but they're going to have to build the towers higher than the tree canopy, and then make sure the vegetation never gets high enough to interfere.

And, of course, they claim it's perfectly safe.  About as safe as standing in front of an operating microwave oven 24/7?  Let the scientific research begin!  It's not all going to be rosy.

This new technology can be metered and costs assigned to customers, which was a failing of Tesla's model more than 100 years ago.  He was more about the science than commercialization.  His wireless electricity was free.

So, yes, this sounds like a huge deal in the world of science and transmission, but in practice it's not going to revolutionize the way electricity is transmitted.  It still relies on cleared ROW (although above ground) and a series of towers above the ground.

I think I'd rather have this.
0 Comments

Regulatory Capture

8/3/2020

2 Comments


Two words a NYT editor needs to learn.  It's why utilities spend money on donations, lobbyists and dishonest public relations campaigns.  The utility is buying influence with regulators and legislators and setting up "cover" to make it look like their decisions are made in the interest of customers.  The utility is governing itself with the blessing of complicit lawmakers and government officials who spend way too much time getting chummy with their sugar daddies.
Taken together, these and other cases demonstrate that too many power and gas companies have sought to exercise undue influence over the governments that nominally control them. Utilities spend lavishly on campaign contributions, dinners, hunting trips for politicians and more. They set up fake citizens’ groups to support their undertakings. And they have been known to ply nonprofit community organizations with “donations” to take public stances that favor the utility — and against the real interests of the people these organizations ostensibly represent.
"Fake citizens' groups" aka front groups have been around since the days of the big tobacco fights.  Ditto the legitimate organizations who sell their support in exchange for utility "donations" that fund them.  It's nothing new.  It's not something that just cropped up in recent years to fight "climate change."  What is different is the new deep state interest in these tactics that has resulted in federal investigations, arrests and indictments.  Why is it that the recent interest in this old playbook seems to be centered around state nuclear bailout legislation?  When are these investigations going to truly serve the people, instead of a political agenda?

The NYT editorial was plodding along swimmingly until the editor just had to toss in the clean energy angle.  Why, if you didn't know better, you may think that only "dirty" fossil fuel companies use these tactics.  Nothing could be further from the truth!  They all do it!  Dirty electrons do not make dirty politics.  Corporate greed makes dirty politics.  "Clean" renewable energy companies use some of the dirtiest politics yet to capture regulators and legislators.

How about if I told you that utilities are using YOUR MONEY to finance their outlandishly expensive persuasive advertising campaigns, their fake "grassroots" front groups, and their supportive public comments?

Stay tuned... it's about to get real in here...
2 Comments
